Building structural steel
Structural steel detailing covered the treatment facility’s building structures within an approximately 650-ton steel package for S&S Steel Fabrication.
Industrial · Van Nuys, California
Steel detailing for a major water reuse infrastructure project.
Project overview
The Advanced Water Purification Facility is part of the Donald C. Tillman Water Reclamation Plant development in Van Nuys, California.
The project is intended to increase water reuse and groundwater replenishment capacity for the City of Los Angeles.
Working for S&S Steel Fabrication, our team provided structural steel detailing for approximately 650 tons of steel.
Detailing scope
Structural steel detailing covered the treatment facility’s building structures within an approximately 650-ton steel package for S&S Steel Fabrication.
Stair steel formed a distinct part of the detailing scope alongside the primary building structures.
Secondary and miscellaneous steel components were included with the building frame and stairs in the coordinated project package.
The model was updated against successive design documents, with affected information reviewed and changes coordinated with the fabricator.
Technical complexity
New drawing sets arrived regularly during detailing. Each issue required comparison with the current model and identification of affected steel information.
Previously submitted RFIs and responses had to be reviewed again after revisions to confirm that earlier answers remained applicable.
Changing documents could affect decisions already reflected in the model. Systematic checks kept earlier assumptions aligned with the latest design information.
Our approach
Managing the changing design required disciplined document control and close coordination with S&S Steel Fabrication.
Our team’s work included:
This process helped the team maintain model accuracy as the design continued to evolve.

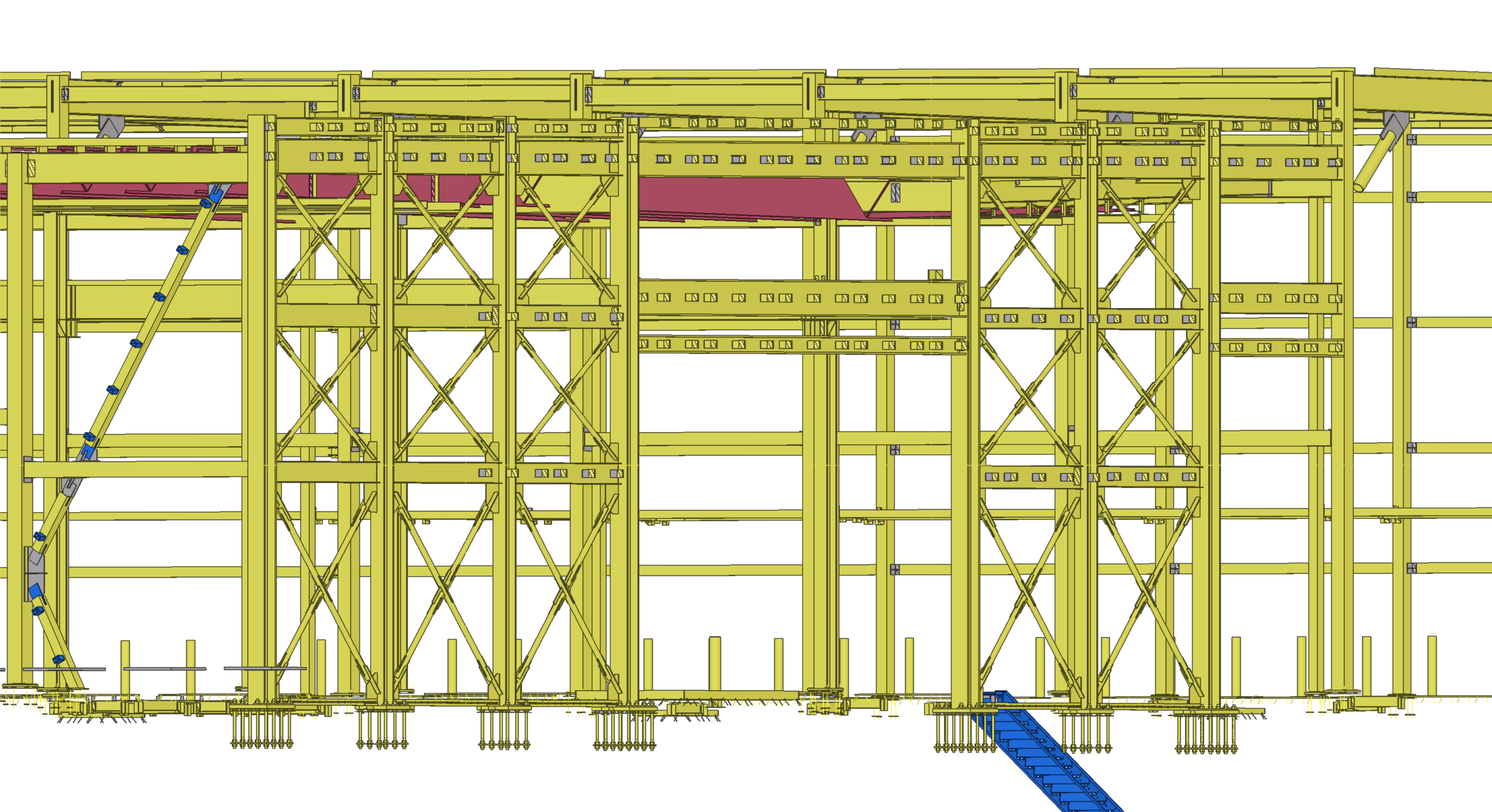

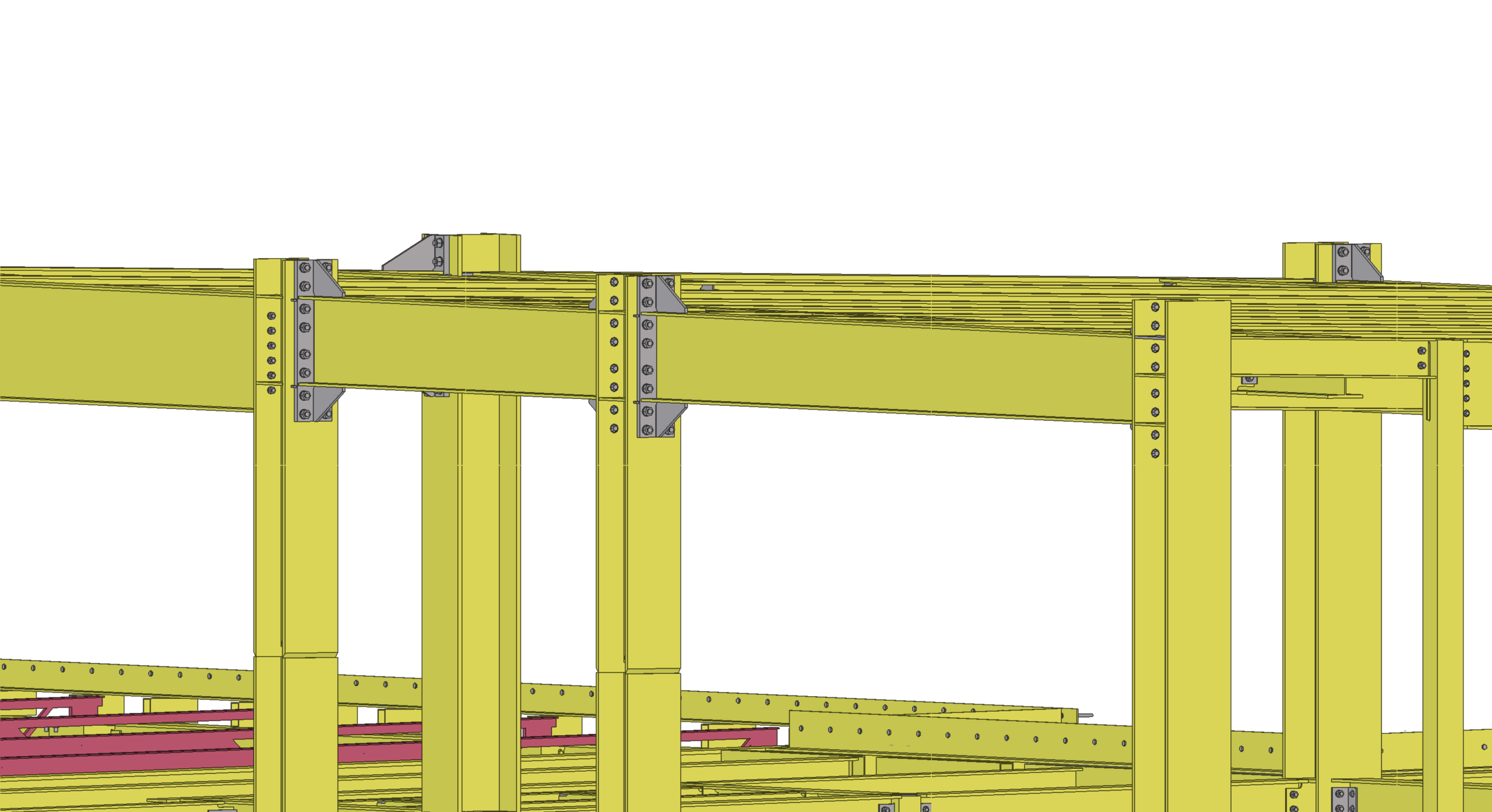

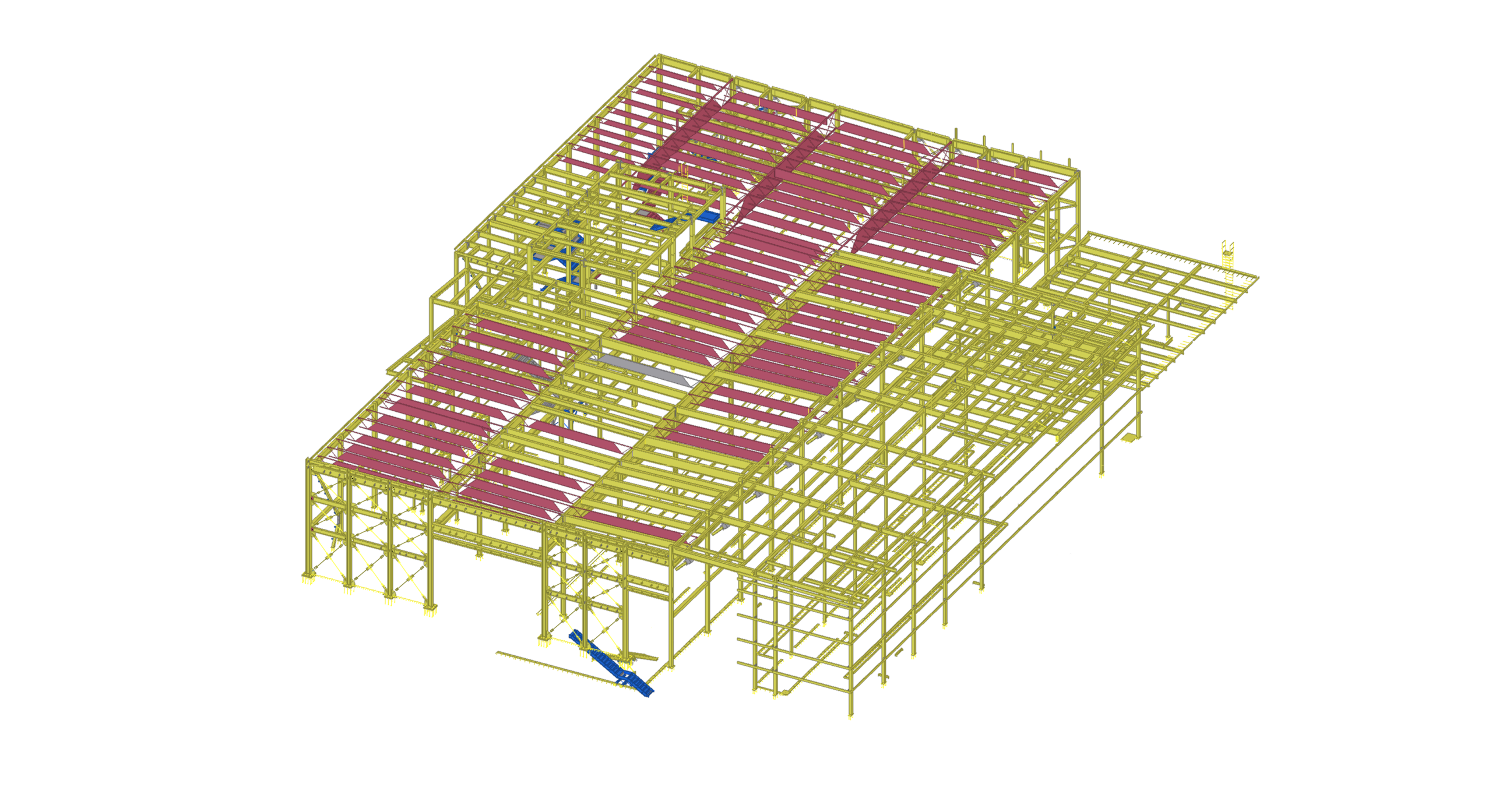

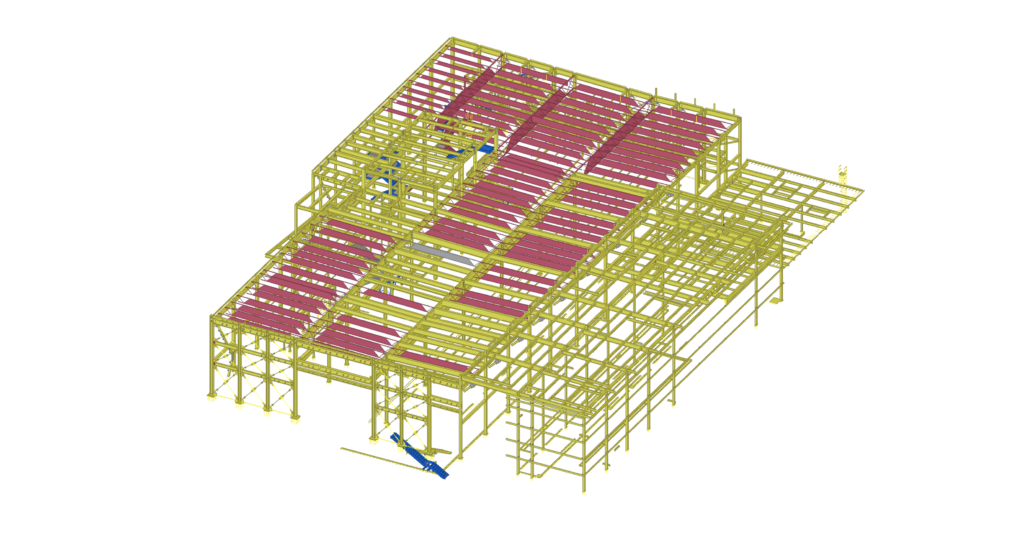

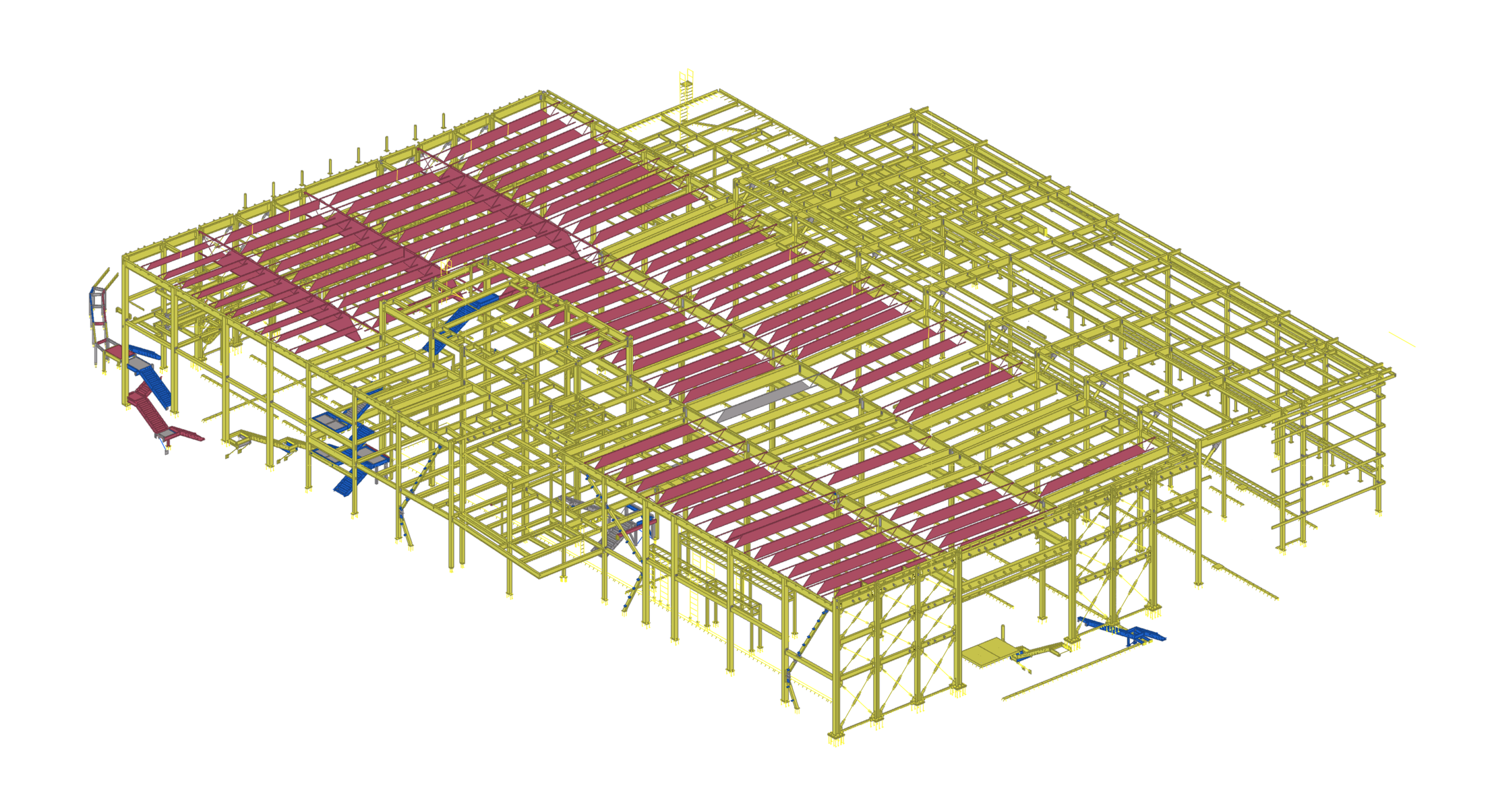

Project animation
Project result
The project reinforced the importance of adaptability in a design-build environment.
Frequent revisions required the team to respond quickly without losing control of earlier decisions or assumptions. Clear RFI tracking, systematic revision reviews and continuous model verification were essential to managing the detailing scope.
